Williamstown Theatre Efficiency Project

Started 2023 with funding from HSP

Members:

  • Kristina Mitreska (PhD, MBA, MSSCM, BBus(Mkt) –  kristina.mitreska@mh.org.au
    • Elective Surgery Reform – Improvement and Innovation Advisor
  • Richard Grygiel
  • Phong Tran
  • Hugh Taylor – Anaesthetist
  • Bonganay, Jhunel
  • Bringmann, Ingra
  • Bernard Hall
  • McKinnon, Julia

Overview of Project

Root Cause Analysis

  • Lack of Anaesthetic Room
  • Lack of Setup Room
  • Timing of Staff needs improvement

Counter-Measures

Root Cause 19 – No sufficient anaesthetic rooms

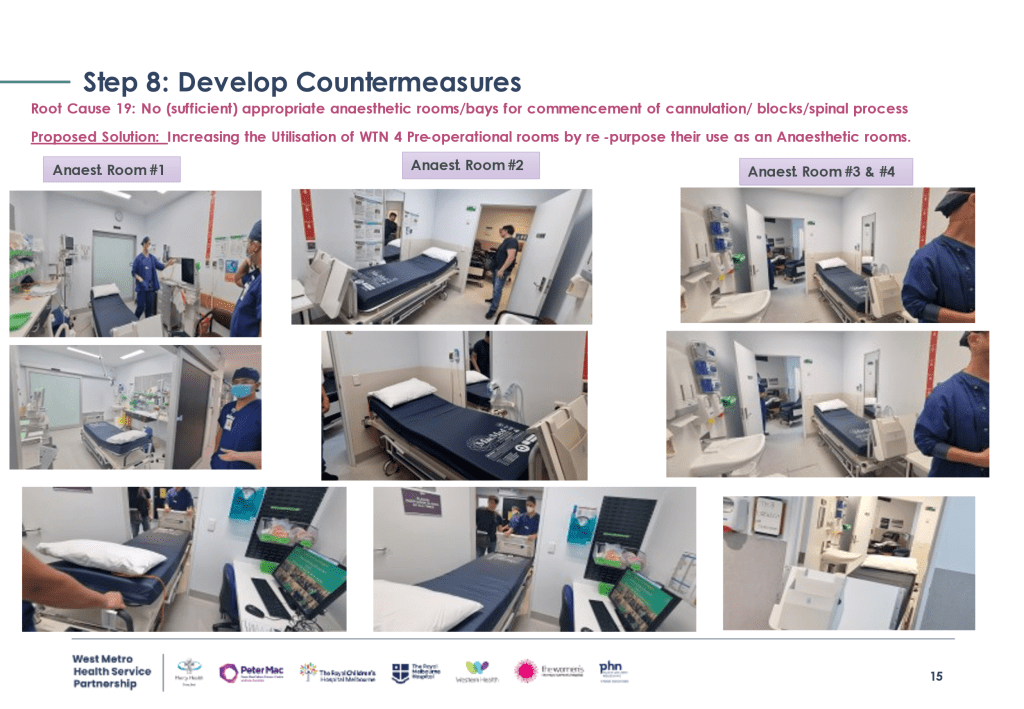

  • Trial of Anaesthetic Room (change storage rooms to anaesthetic room)
  • Theatre Setup
    • The computers table / seating to be removed from rooms 2, 3 & 4 & replaced with WOWs
    • Provision/supply of 3 x Trolleys / 3 x Portable monitoring equipment / 3 x Cannula,
    • Check the suction work (supply portables) & Emergency buzzer & rectify the issues, if present
    • 3 x door upsize & replace to sliding doors instead, #2 Anaesthetic room door repositioning at the front, 3 x repositioning of the oxygen equipment,  3 x wall mounting of the phones
  • Costs
    • 3 x Trolleys (availability for initial trial/ purchase)/ 3 x Portable monitoring equipment / 3 x Cannula,
    • Check the suction work (supply portables) & Emergency buzzer & rectify the issues, if present
    • 3 x Provide portable computer trolley /WOWs (JB)
    • 3 x door upsize & replace to sliding instead, #2 Anaesthetic room door repositioning, 3 x repositioning of the oxygen equipment,  3 x wall mounting of the phones
    • Repositioning of the sinks (behind the current door)

KPIs

  • On time start First Morning sessions (planned session time vs actual session start time)
  • Surgery start (8:30am and also we will measure against 8:45)
  • Anaesthesia start (8:15)
  • 1st case: Clerical to nurse admission (<30min)
  • 1st case: Nurse admission to anaesthesia start (<30min)
  • Underruns: (No. of sessions finishing >30mins before 12:30 and 1730)
  • Overruns: (No. of sessions finishing >30mins after 1230 and 1730)

Performance Reports

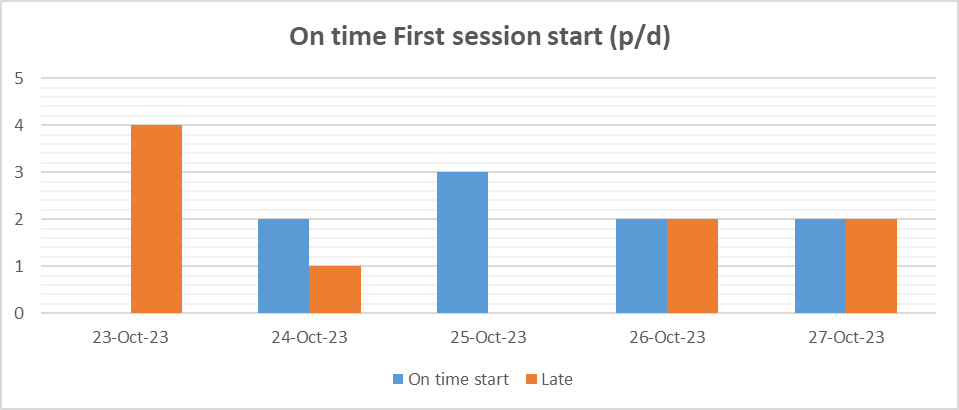

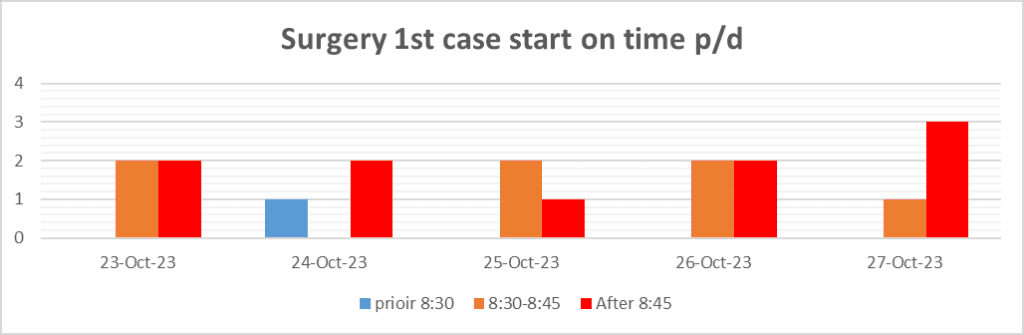

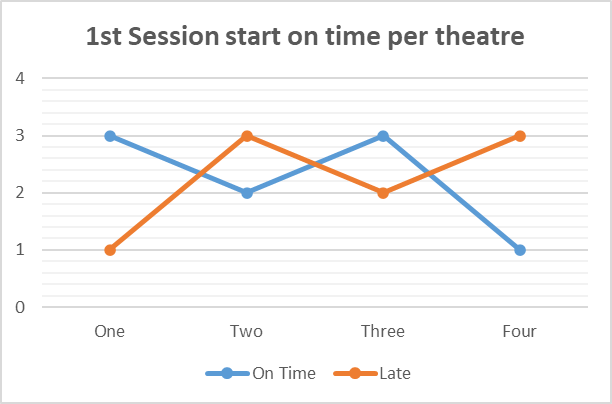

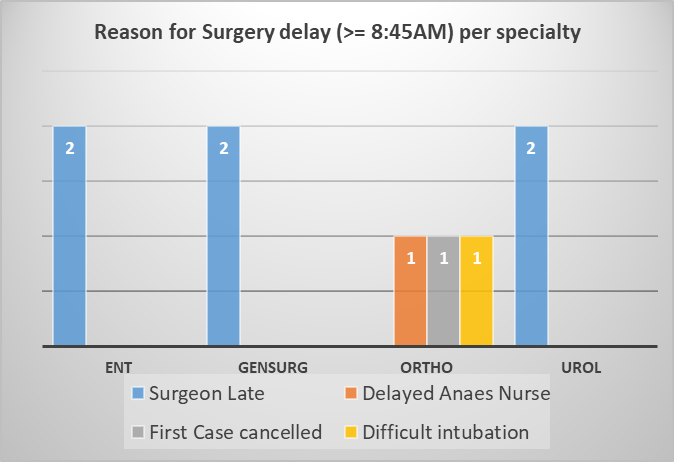

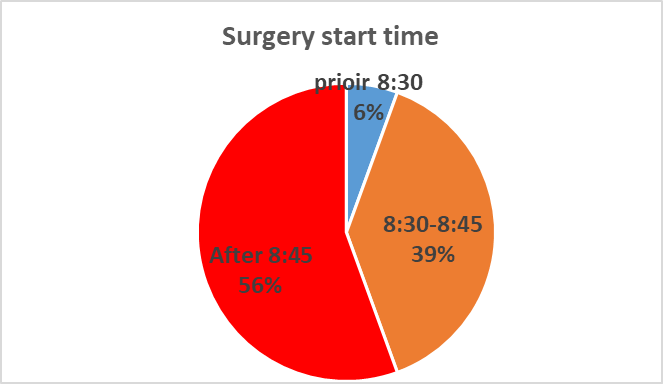

Below is an example of the KPIs that are being measured

Link to all the progress reports
